Siplast Material Estimating Calculator UX/UI Design

Replacing a PDF
with a System

Designing a dynamic material estimating calculator that cut contractor estimation time from 2 hours to 12 minutes, drove a 3.2× increase in engaged sessions, and achieved an 89% task completion rate after launch.

Enterprise Tool System Design Cross-functional B2B / Construction Web

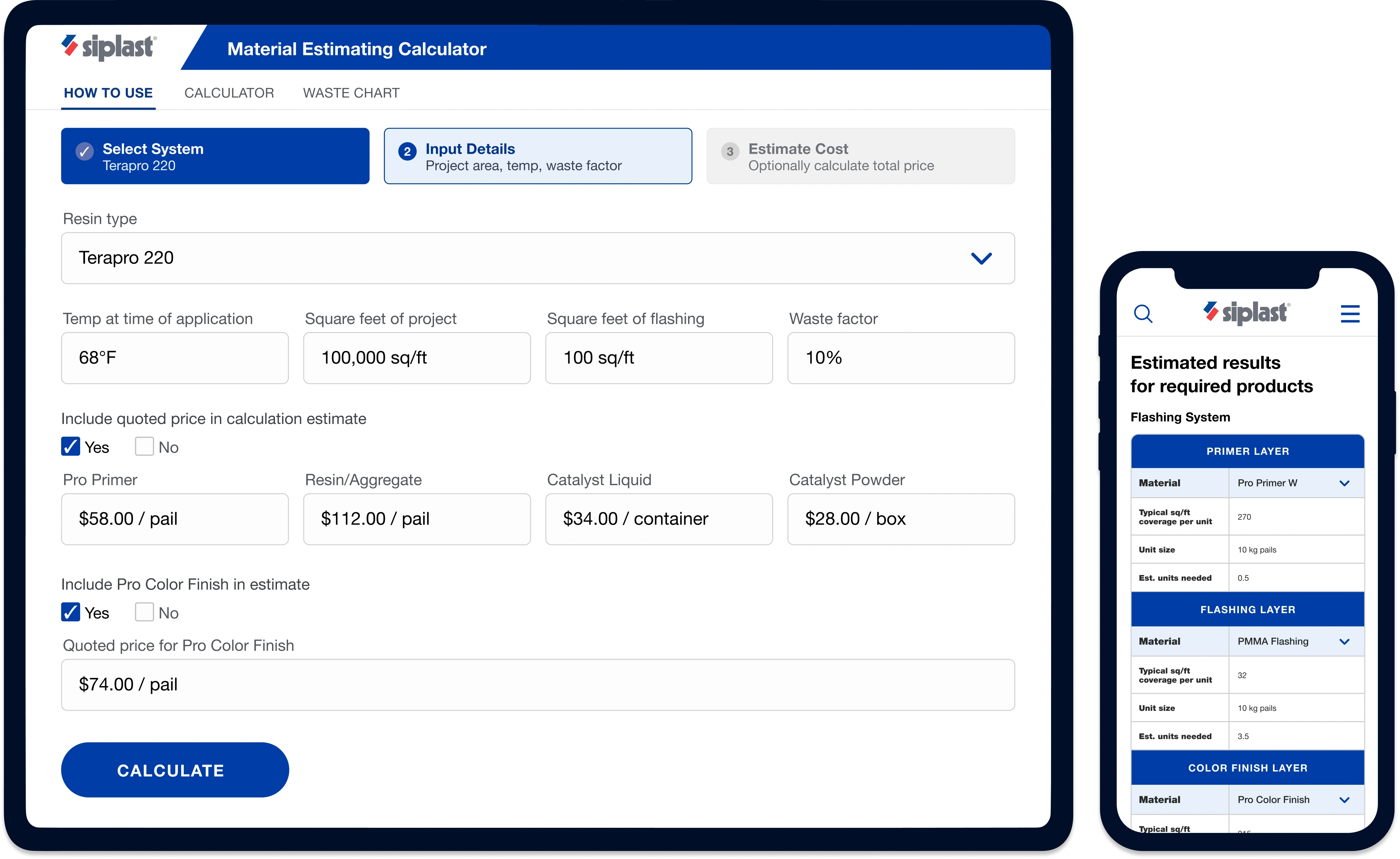

Siplast material estimating calculator on desktop and mobile
My Role
Sole designer
Collaborators
Product, Engineering, Business Stakeholders
Platform
Web / Desktop + Mobile
Outcome
2 hrs → 12 min, 3.2× engaged sessions

The starting point

Siplast makes commercial roofing systems installed by contractors on large-scale jobs. Before any project starts, contractors need to estimate exactly how much material they need: primer, membrane, flashing, and catalyst, calibrated to project size, temperature, and substrate. Getting it wrong meant over-ordered materials, delayed jobs, and bids submitted with incorrect numbers.

The tool Siplast gave them to do this was a stack of printed PDF guides.

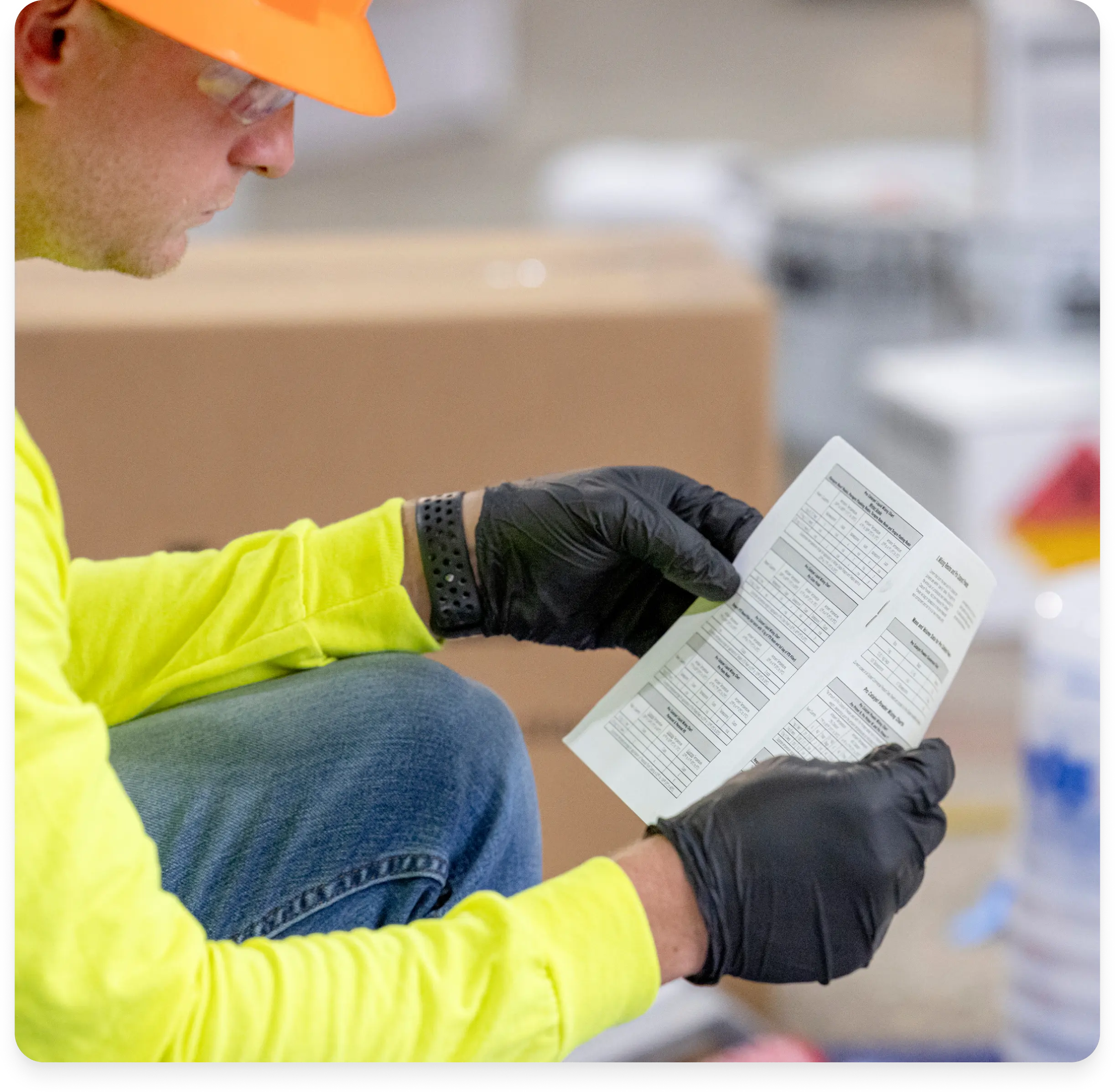

Contractor in safety gear reading a printed PDF guide on a job site
The Old Workflow
  • Manual cross-referencing of printed PDF tables
  • No validation or error checking
  • 2 hours per estimate, per project
  • No way to save, share, or revisit work
  • Every job required starting from scratch
The Goal
  • Dynamic inputs that adapt to project variables
  • Real-time validation and calculation feedback
  • Structured outputs by material layer
  • Save, share, and export to PDF
  • Scalable across multiple roofing systems

"Hours per estimate. No validation. No real-time feedback. And every job is different: different square footage, substrate, temperature, waste factor. The PDF couldn't adapt."

A workflow built on the wrong foundation

The problem wasn't that contractors couldn't do the math. It was that the process forced unnecessary cognitive work at every step, with no way to catch mistakes before they became costly.

01

Manual and fragile

Paper-based cross-referencing with no validation meant errors weren't caught until materials arrived on site, or didn't arrive at all.

02

Zero adaptability

Every project varies by square footage, substrate, and temperature. The static PDF couldn't account for any of it without manually reworking every calculation.

03

No feedback loop

Contractors had no confirmation that numbers were reasonable. There was no way to save, share, or hand off results when finished.

Owning the problem end-to-end

I was the sole designer on this project. I worked directly with product and engineering to define the logic, build the experience, and ship it. My work spanned three phases, and the most important happened before any screen was designed.

Phase 01

Discovery & alignment

Working with stakeholders to map what contractors actually needed, not just what the PDF covered. Understanding coverage rates, waste factors, material dependencies, and real project variability.

Phase 02

System architecture

Defining the calculation logic alongside engineering: what inputs were needed, how they flowed into outputs, how to handle edge cases without creating a complicated UI. Product logic work, not UI work.

Phase 03

Interface design

Translating system logic into an experience that felt simple, even when underlying inputs were complex. Progressive disclosure, real-time feedback, and outputs contractors could save and share.

Designing the logic before the UI

Material estimation isn't a simple calculator, it's a multi-variable engine. The right quantity of any material depends on square footage, temperature, substrate type, application method, and anticipated waste. Change one input, and the outputs cascade. I worked with engineering and product to define the calculation architecture first.

The system was also designed to scale across multiple roofing products from day one, not just one. The final architecture supports 4+ roofing systems, 5 substrate types per system, and 12+ material combinations, each with its own inputs, coverage rates, and calculation paths.

01
Inputs
User inputs
  • Project details
  • Square footage
  • Temperature at application
  • Material system selection
  • Waste factor
Defined with stakeholders
02
Logic
Calculation engine

e.g., how waste factors and coverage rates needed to remain editable without breaking downstream outputs.

  • Coverage rates per material
  • Waste factor adjustments
  • Business rules
  • Material database
Aligned with engineering
03
Outputs
Structured results

e.g., field testing revealed contractors needed total unit summaries, not just per-system breakdowns.

  • Material quantities by layer
  • Cost breakdown (optional)
  • Reference charts
  • Recommendations
Validated with contractors
04
Actions
Save / Share / Export
  • Save estimates
  • Share with project team
  • Export to PDF
  • Print results
Tested in the field

What we debated and why

The most interesting design challenges on this project weren't visual, they were structural. Here's how we solved them.

01

How to handle input variability

Surfacing all inputs at once was comprehensive but overwhelming. We used progressive disclosure: required inputs first, optional below a clear break, keeping it simple for standard jobs and flexible for complex ones.

→ Progressive disclosure by context group
02

Real-time vs. submit-to-calculate

Contractors adjust inputs iteratively and want to see results immediately. We chose real-time feedback for core fields, with an explicit Calculate step for the full output: responsive without feeling unstable.

→ Hybrid: live feedback + explicit calculate step
03

Output structure: flat list vs. layered view

A flat material list didn't match how contractors think about a job. Restructuring results by application layer (Primer → Flashing → Field Membrane) matched their existing mental model with no re-learning required.

→ Layer-based output structure
04

Digital-only vs. hybrid workflows

Contractors plan digitally but often work from paper on site. We added PDF export and save-as-estimate to bridge both, so the tool retained its value even without connectivity.

→ Save, share, and export to PDF

From input to estimate in three steps

Designed around one principle: reduce friction without sacrificing accuracy. System selection filters the form, optional sections appear on demand, and results follow the sequence of how materials are applied on site.

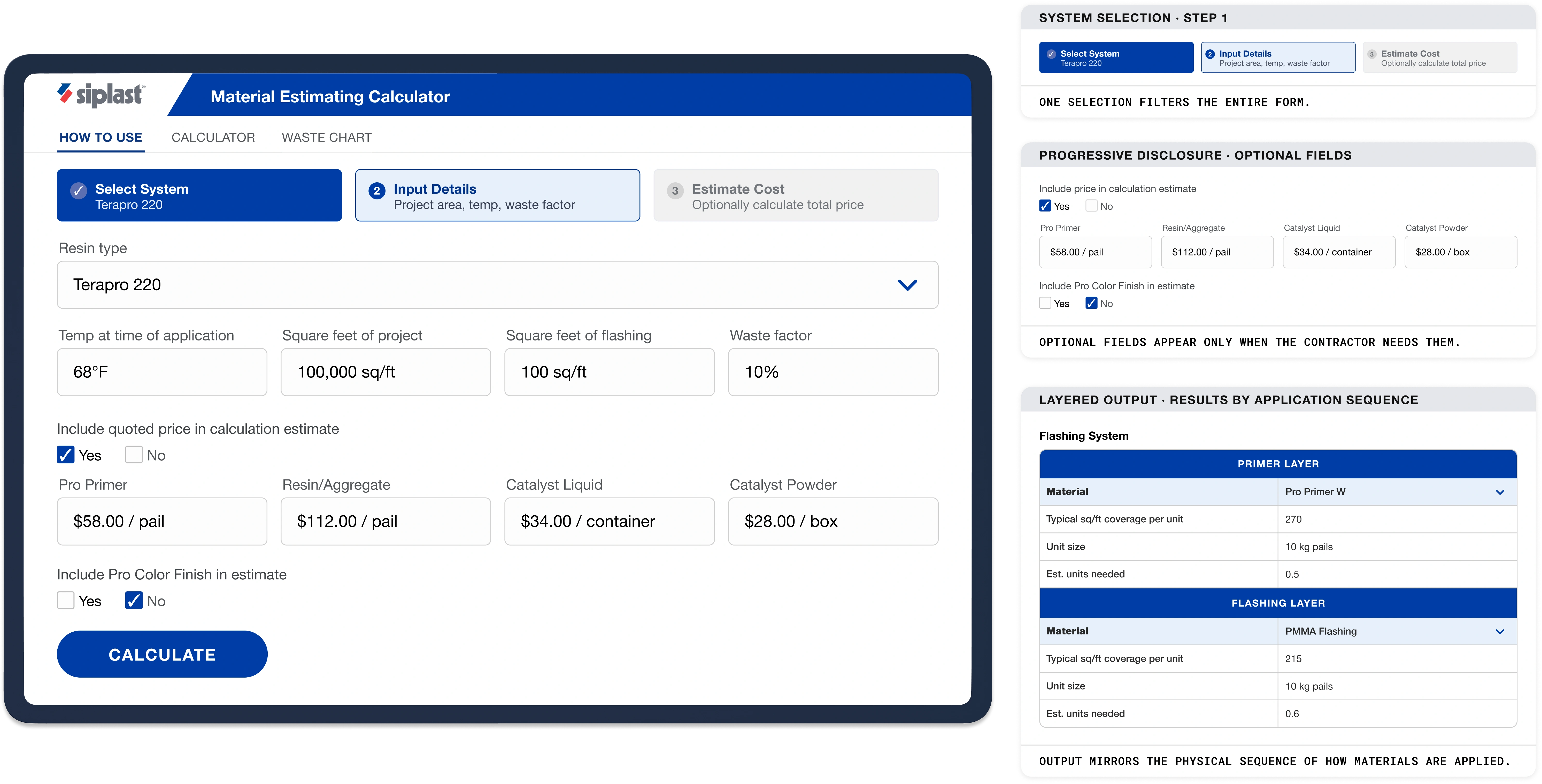

Siplast material estimating calculator showing the input view alongside system selection, progressive disclosure, and layered output callouts

Contractors bring their own prices. The tool does the rest.

Once materials are calculated, contractors can optionally enter their quoted prices per unit. The tool generates a full cost breakdown by material and a total estimate: ready to save as PDF, share with a project manager, or use for bid preparation.

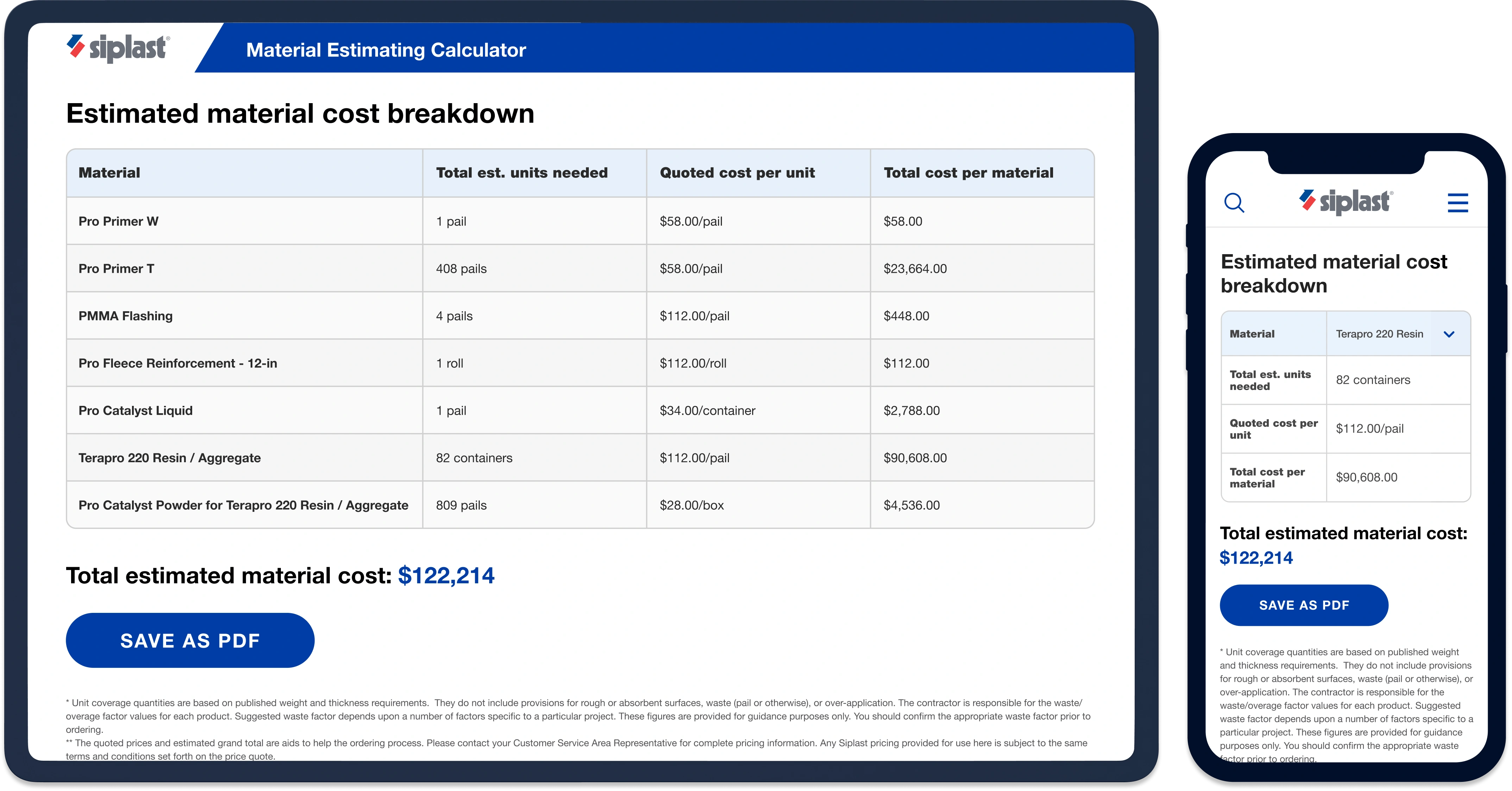

Desktop and mobile views of the estimated material cost breakdown showing quantities, unit prices, totals, and Save as PDF action

What changed after launch

Replacing a printed PDF with a digital tool only works if people actually use it. The numbers below reflect contractors choosing the tool over their existing process, repeatedly.

65%
Reduction in estimation time
2 hours 12 minutes per estimate
3.2×
Increase in engaged sessions
Manual lookup Interactive tool
89%
Task completion rate
Incomplete estimates Full calculations

What I'd do differently

The calculator launched successfully and drove real adoption, but there are three things I'd approach differently given more time and access.

01 Research

Earlier contractor involvement in the logic phase

  • Contractors were involved in shaping the output format, but later in the process than they should have been.
  • I'd involve contractors earlier to help define the output structure so format decisions are grounded before iteration begins.
02 Onboarding

A stronger first-use experience

  • The tool works well for contractors who already know what inputs to provide. It provides no real on-ramp for first-time users.
  • I'd add smart defaults and inline tips about what each field affects so contractors can get to a useful result on the first try.
03 Strategy

Defined success metrics before building

  • We measured impact after launch instead of defining what success looked like before we built.
  • I'd define what success looks like upfront so the team is designing toward something specific, not discovering it after launch.

The interface is the last mile.

The real design work, the part that determines whether a tool is trusted and used, happens before any screen is built: in the logic, the structure, and the alignment with the people who understand the problem from the inside. The discipline isn't about making things look good. It's about making complex systems feel inevitable.
